For decades, residents of the East Bronx have dealt with some of the longest, most frustrating commutes in New York City.
A fast, direct train ride into Manhattan’s West Side always felt out of reach for hundreds of thousands of people, but that is finally changing.
The MTA is now deep into construction on the Penn Station Access project, a roughly $3.1 billion venture that will connect Metro‑North directly to Penn Station and reshape regional transit.
By using Amtrak’s existing Hell Gate Line, the project will extend Metro‑North’s New Haven Line straight into Penn Station via the Bronx.
It’s the largest expansion of Metro‑North service since the railroad was created in 1983, and much of the heavy lifting is happening right now in plain sight along the Northeast Corridor.

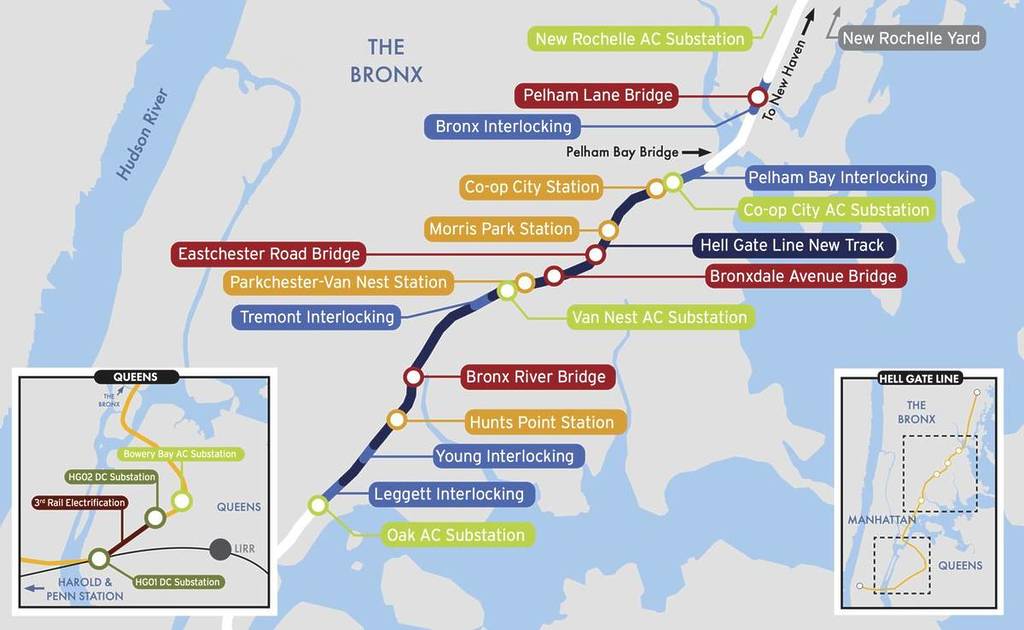

The route: four brand-new Bronx stations
At the heart of the project are four new, fully accessible Metro‑North stations in the East Bronx:
- Hunts Point
- Parkchester / Van Nest
- Morris Park
- Co‑op City
These neighborhoods are currently underserved by rail, forcing many riders to rely on slow buses and multi-transfer subway trips.
Once Penn Station Access is complete, an estimated 500,000 Bronx residents will live within one mile of a Metro‑North station, with a one‑seat ride into Midtown West and Moynihan Train Hall.

Where things stand in 2026

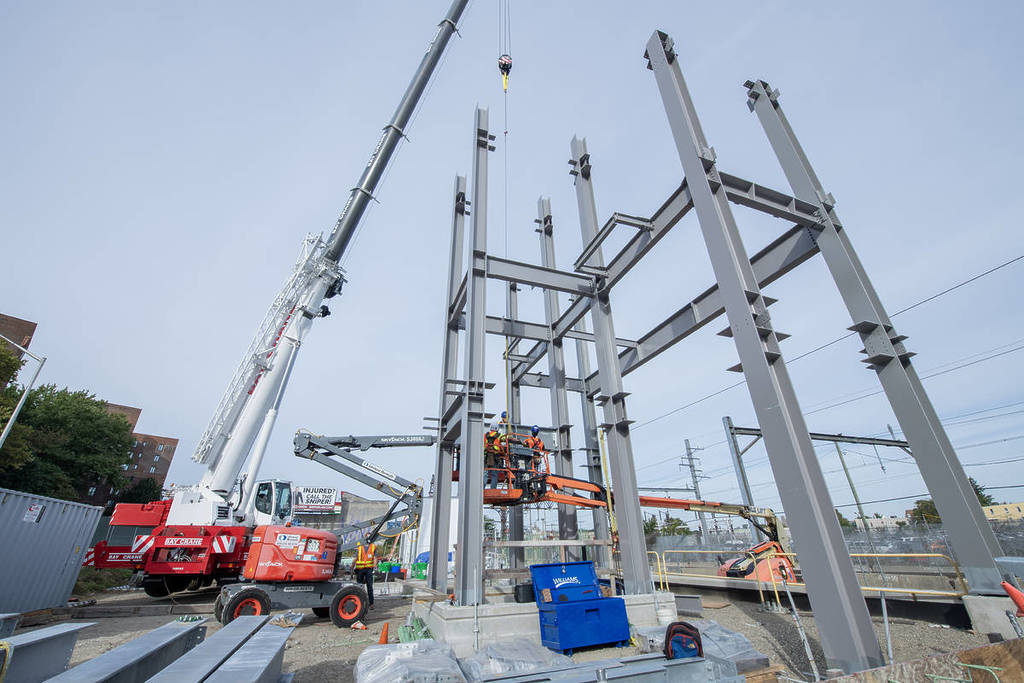

Right now, construction crews are actively reshaping the corridor.
Along the Hell Gate Line in the Bronx, teams are working on new and rebuilt track, modern signals, traction power upgrades, drainage, and bridge rehab, plus foundations for the future stations.
The project will ultimately expand the Amtrak right‑of‑way from two to four tracks, build or upgrade nearly 19 miles of track, add new interlockings and substations, and reinforce multiple bridges.
The timeline, however, has shifted:
- The project originally targeted 2027 for completion.
- After early delays and limited track access from Amtrak, officials moved that to late 2027 / 2028.
- As of late 2025 and early 2026, MTA officials now say full Penn Station Access service is projected for around 2030, citing ongoing coordination issues with Amtrak.
There is still a chance of an earlier, limited launch: at a January 2026 community board briefing, the MTA said temporary platforms could allow limited service at three Bronx stations as early as 2027, but only if Amtrak provides more track outages and staffing support.
In other words, the big vision is intact, but the exact opening date depends heavily on how quickly the MTA and Amtrak can align.
Why this is a game changer for New Yorkers
When trains finally start running, the impact for East Bronx riders will be huge:
- Commute times slashed: East Bronx passengers traveling to Penn Station could save up to 50 minutes each way, cutting some trips from about 75 minutes to 25.
- Regional one‑seat access: Direct connections to New Jersey Transit, the Long Island Rail Road, and Amtrak at Penn/Moynihan will make cross‑region trips much smoother.
- Less traffic, cleaner air: More people choosing rail over driving is expected to reduce local car traffic and emissions.
- Catalyst for neighborhood investment: City and federal officials say the new stations could support job access for roughly 200,000 positions within walking distance and encourage new housing and economic development around each stop.

Looking ahead
New Yorkers may have to wait a bit longer than originally promised to tap their OMNY cards at new Co‑op City or Morris Park platforms, but the momentum in 2026 is real.
Tracks are being laid, foundations poured, and bridges rebuilt across the Bronx—quietly setting the stage for a historic shift in how the city and its suburbs connect.
Penn Station Access won’t solve every transit inequity overnight, but it’s one of the most consequential rail projects underway in the region.
As construction continues and timelines sharpen, East Bronx riders are finally on the cusp of getting the kind of direct, fast Manhattan access they’ve been promised for generations.
