New York City is the City That Never Sleeps–but it’s also the city that never stops walking. Soon, the 8.48 million New Yorkers who rely on their feet to get around will have a much grander stage to stroll upon.
City officials are officially moving ahead with a massive $156 million transformation of Broadway, turning six additional blocks into a permanent, pedestrian-focused corridor. By 2031, the stretch of Broadway between 21st and 27th Streets will trade its fading paint and plastic bollards for world class concrete plazas.
From “Pop-Up” to Permanent
If you’ve walked through Flatiron or NoMad, you’ve likely seen the tan gravel paint and planters used to differentiate between pedestrian space and space for cars. While these blocks were fast-tracked with temporary materials like tan paint and plastic planters during the pandemic, they were always intended to be the testing ground for a much more ambitious, permanent streetscape.
And now, according to a February 2026 Department of Transportation (DOT) presentation, the city is ready to make it official.
The new “Broadway Vision” plan moves beyond the quick-build toolkit to create a cohesive, high end public realm.

What the $156 million overhaul includes
- Permanent Concrete Plazas: replacing painted gravel with level, durable stone and concrete
- Widened Sidewalks: giving pedestrians more room to breathe in high-traffic NoMad
- Two-Way “Social” Cycling: improved bike lanes designed for slower, safer travel
- Infrastructure Upgrades: $67 million of the budget is dedicated to essential underground sewer and water main work
- Curated Amenities: new landscaping, permanent seating, pedestrian scale lighting, and concession kiosks for food and drinks

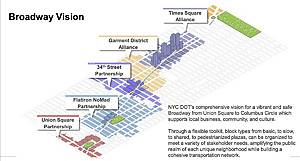

The Bigger Picture: “Broadway Vision”
This isn’t just a localized fix–it’s part of the broader Broadway Vision Master Plan. The goal is to create a “pedestrian-first” spine from Union Square all the way to Columbus Circle.
While the 21st to 27th Street stretch is entering the final design phase now, the DOT also has its sights set on the next phase: 27th Street to 33rd Street (Herald Square). While that phase is currently in the “pre-scoping” stage, the ultimate goal is a seamless shared street experience where vehicles are treated as guests, not the priority.

When will it be finished?
New Yorkers will need to pack a little patience. Because the project involves significant underground utility work, the timeline is longer than a standard repaving:
- Final Design: 2027
- Construction Start: 2028
- Expected Completion: 2031
The DOT already completed the phase between East 17th and East 21st Streets. With this new injection of $156 million, the slow chugging of Broadway’s pedestrianization is officially picking up speed.
How this affects New Yorkers
The Flatiron NoMad Partnership is seeking a “Major Concession” status for these plazas, which would allow for more “positive activations”—think: more outdoor markets, art installations, and managed seating areas that make the city feel more like a backyard and less like a highway.
